1st Flr Remodel: Ann Arbor Hills
Completed July 2024
AFTER PHOTOS
Our project is a 1980s, single story house with a walk out basement, located in Ann Arbor Hills. Like many of the homes Rochman Design Build works on, our team will be taking out the walls between the kitchen and dining room to give our clients more flow and space. We will also be re-arranging the back entry, renovating the mudroom, creating a working pantry, and - of course - renovating the kitchen. The living room will also be getting an addition of a light shaft as well as built in shelves and the bathroom will go from a 1980s feel to a more Zen space, complete with a free standing tub.
Please follow along this current work blog to see the transformation.
January 17, 2024
Remember this photo because it’s going to look SO different once we’re done 😊
Time to lay down protection everywhere and on everything.

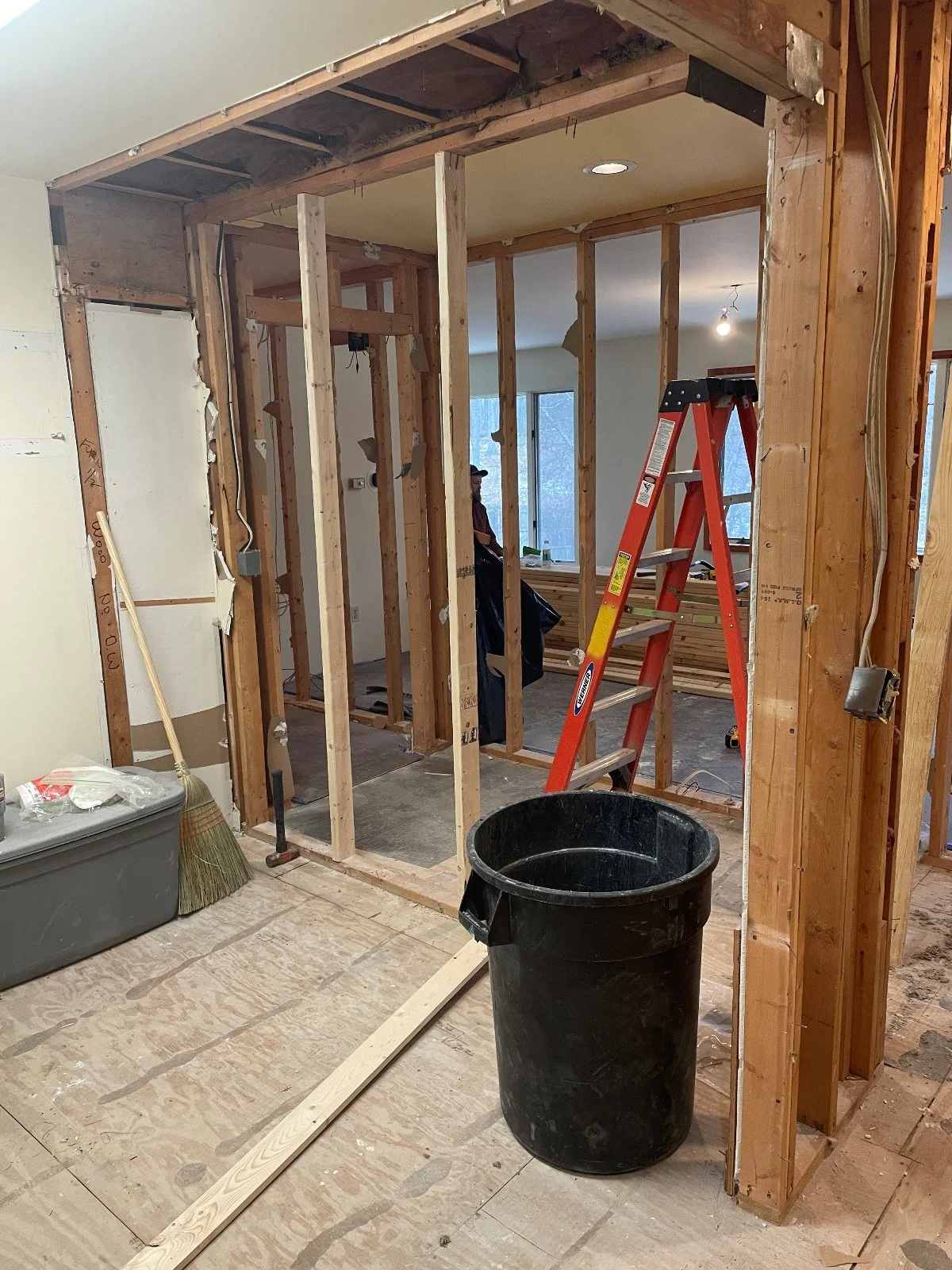

January 29, 2024

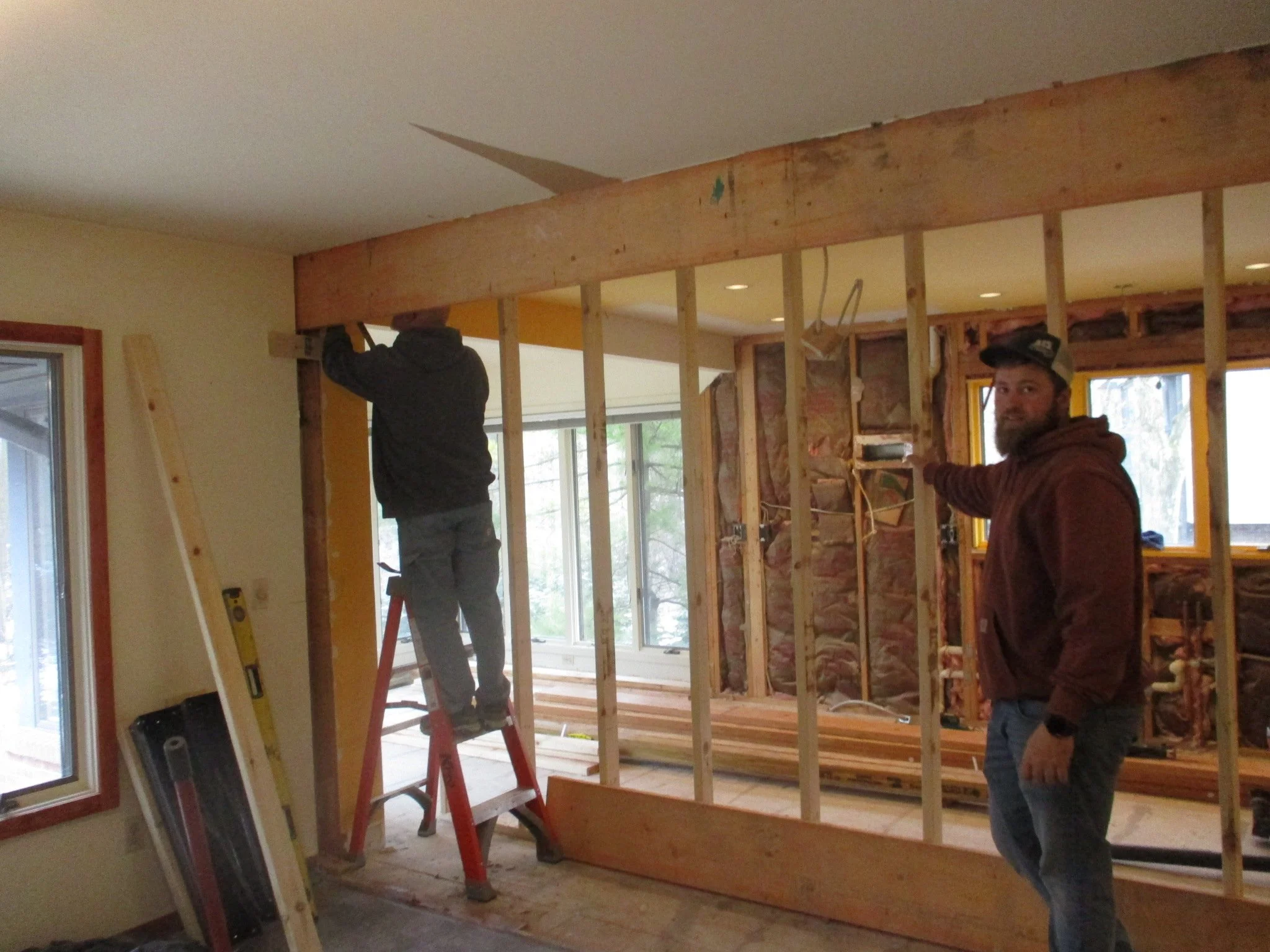

Framing has started and is going full force 😊

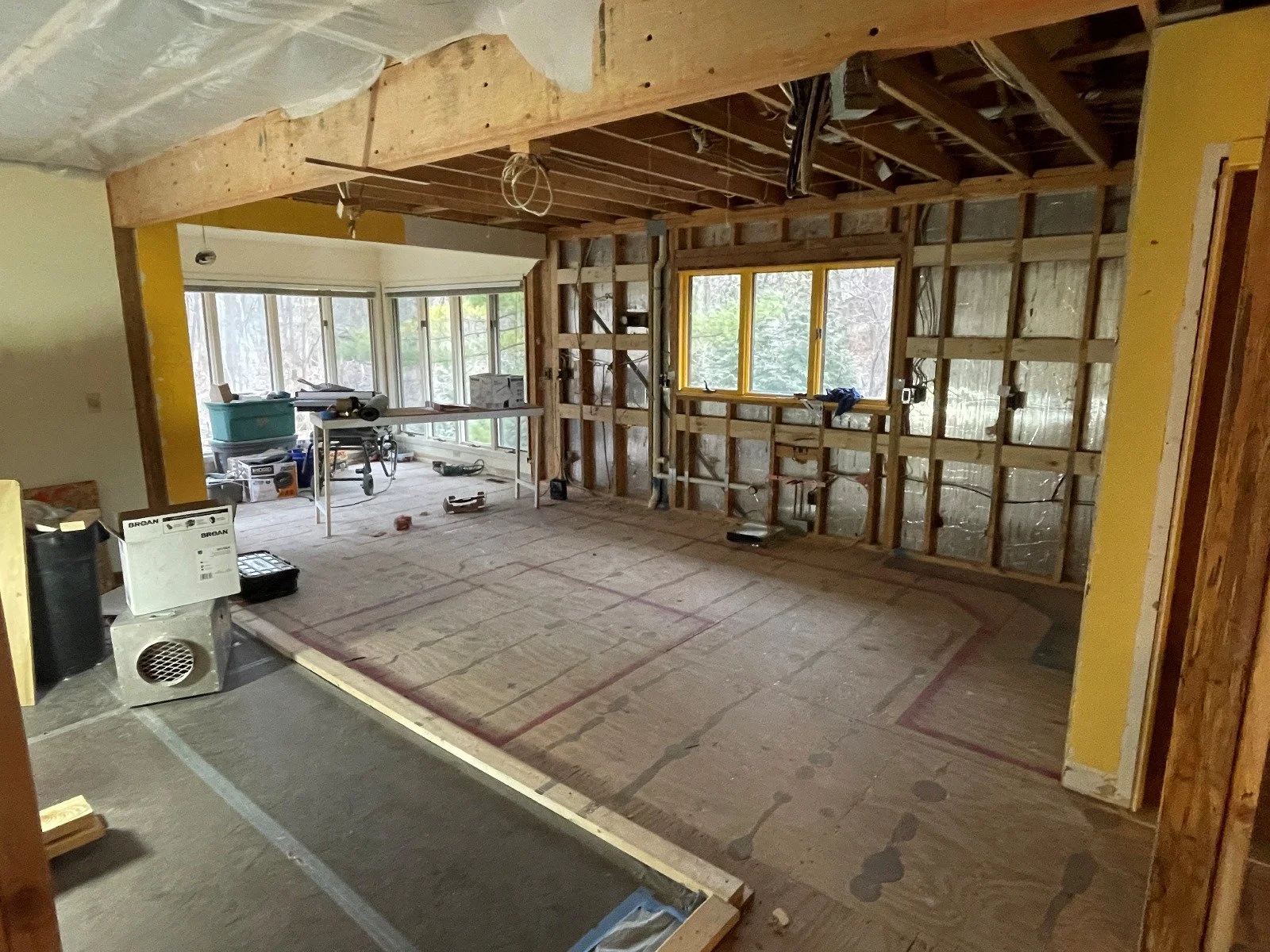

February 8, 2024

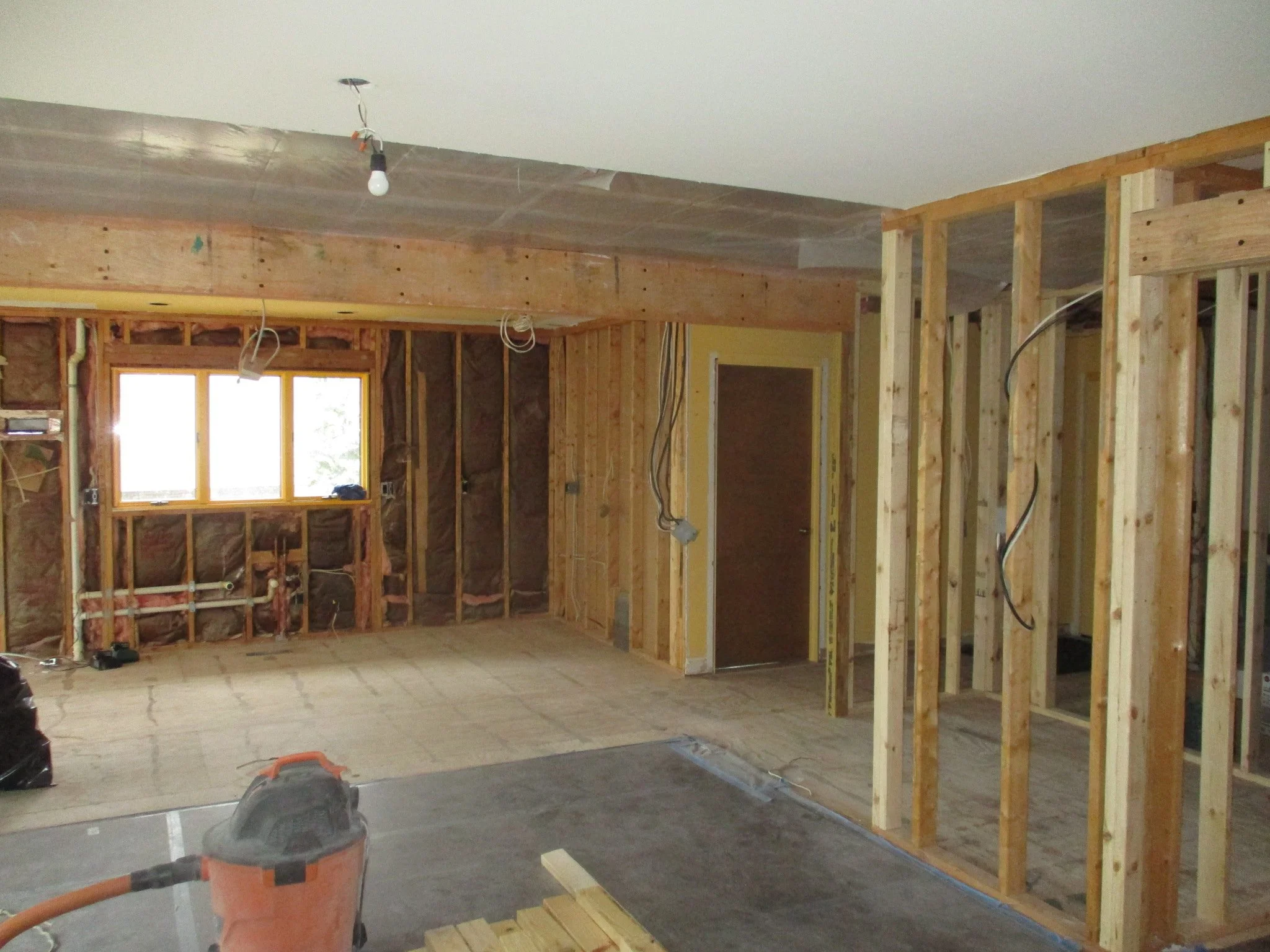

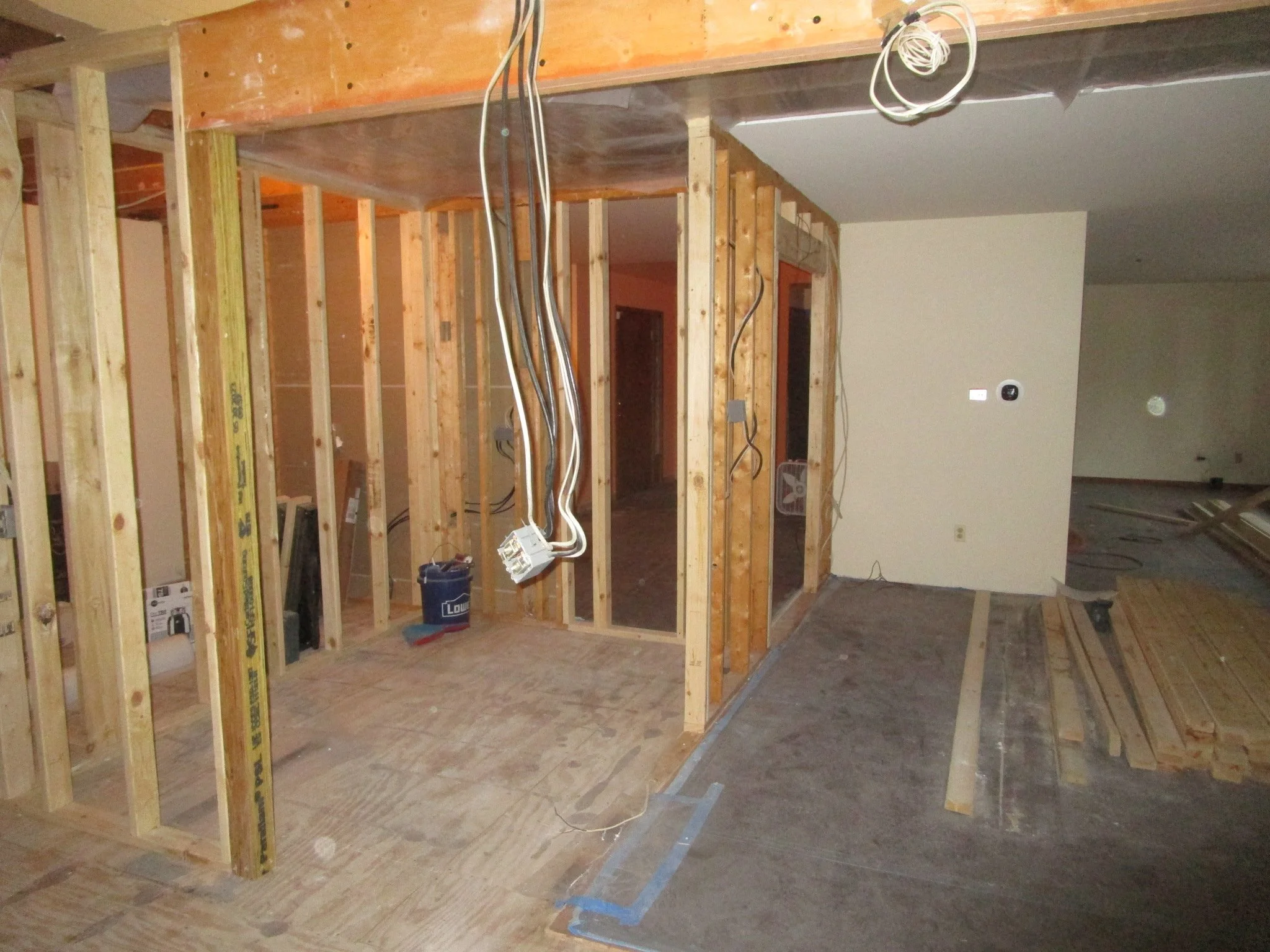

Demolition and framing are done. We are now waiting for our trades’ people to arrive.
The above image shows what will be the kitchen. The image below shows the future pantry.
February 16, 2024

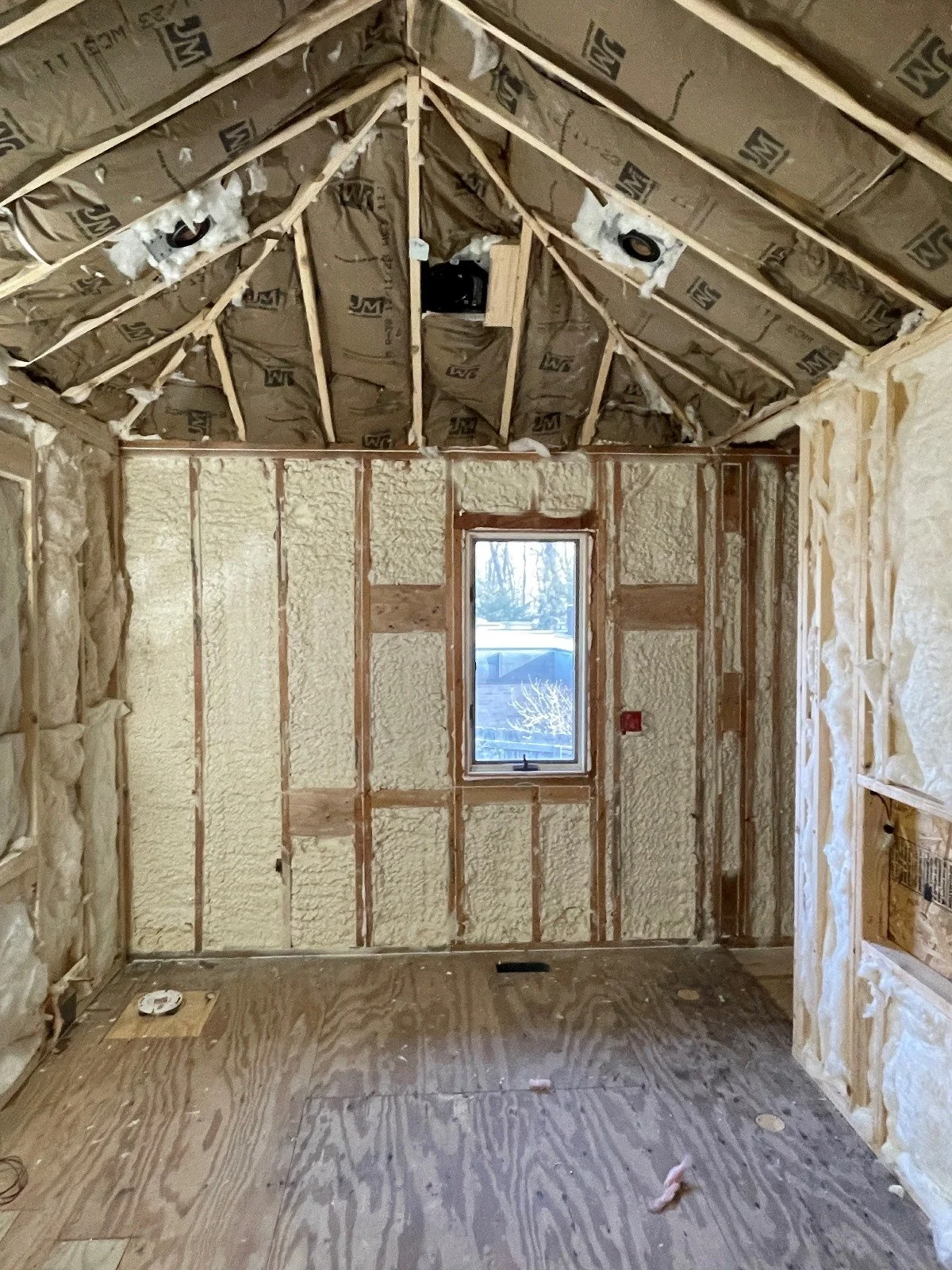

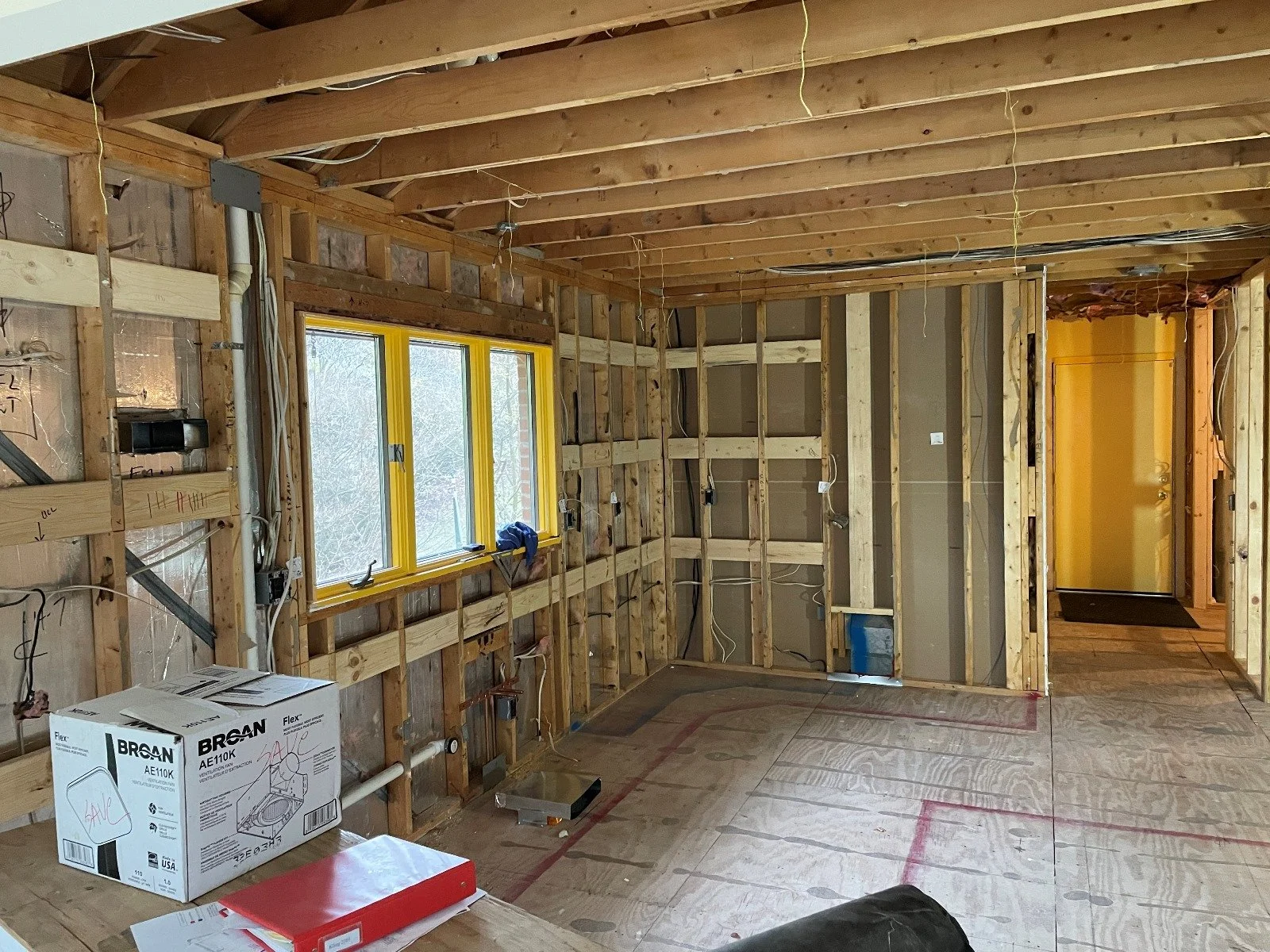

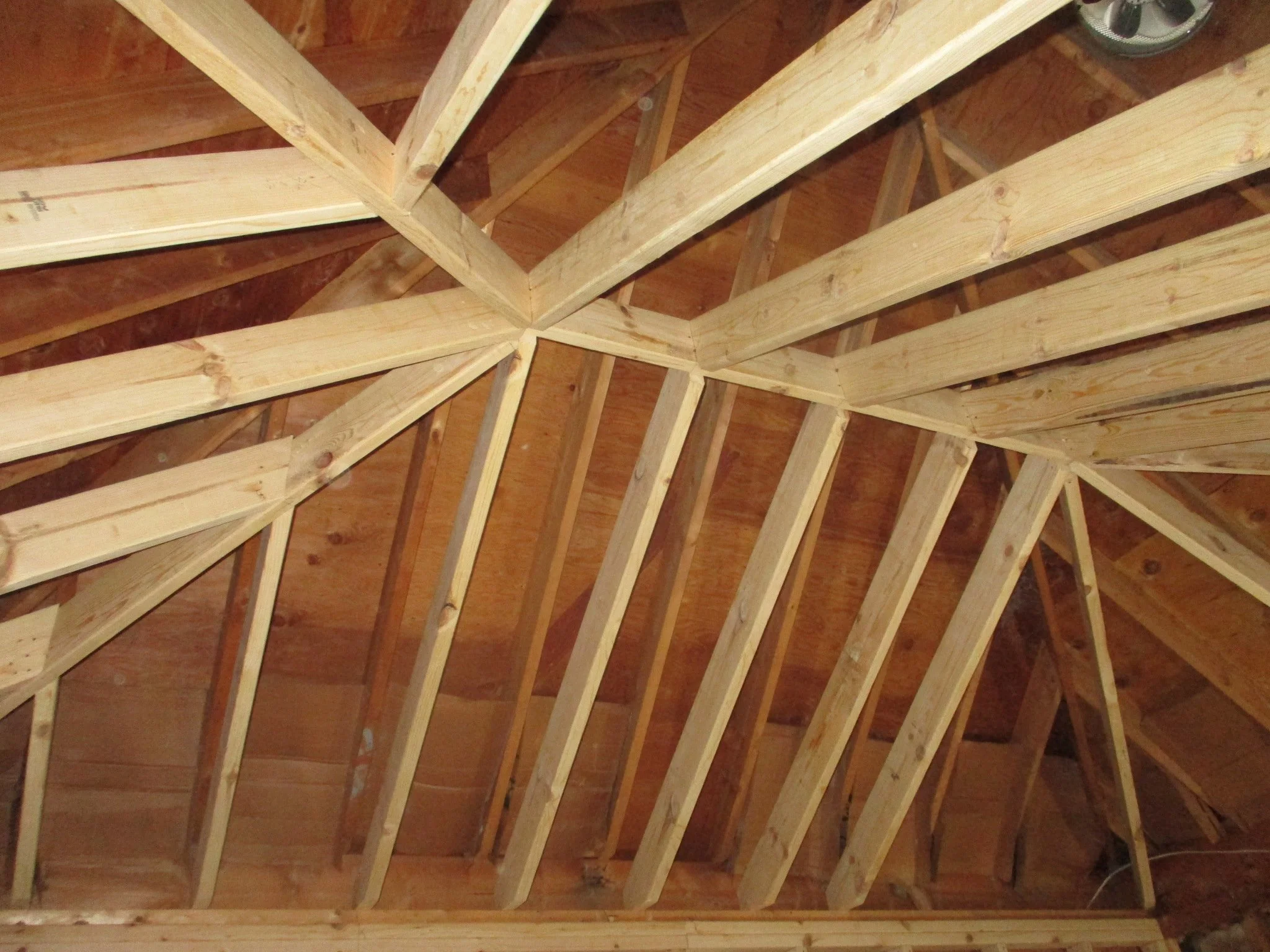

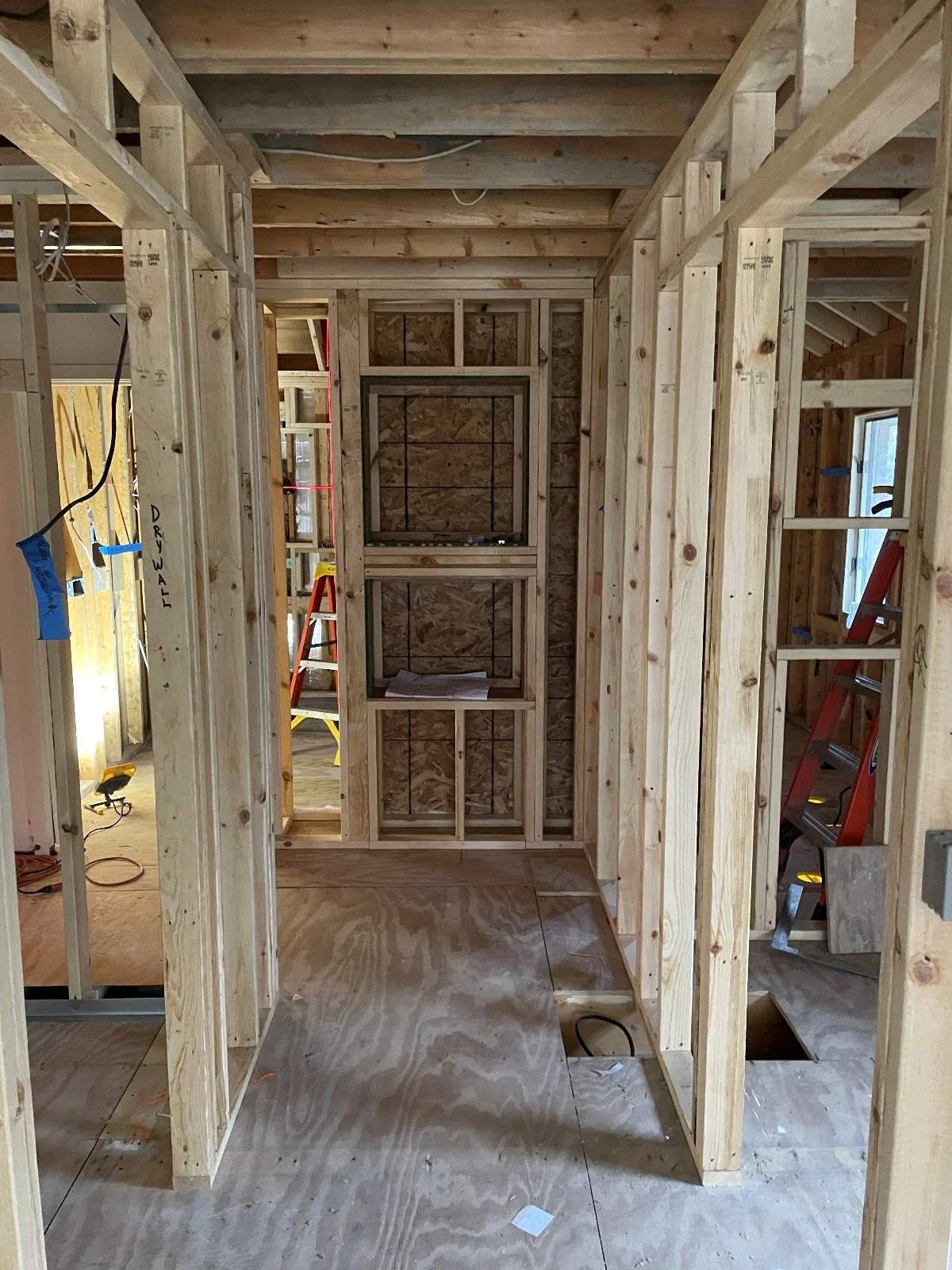

Primary bath has lowered cathedral ceiling framed under existing roof.
Kitchen / Dining room wall remodeled for open floor plan.

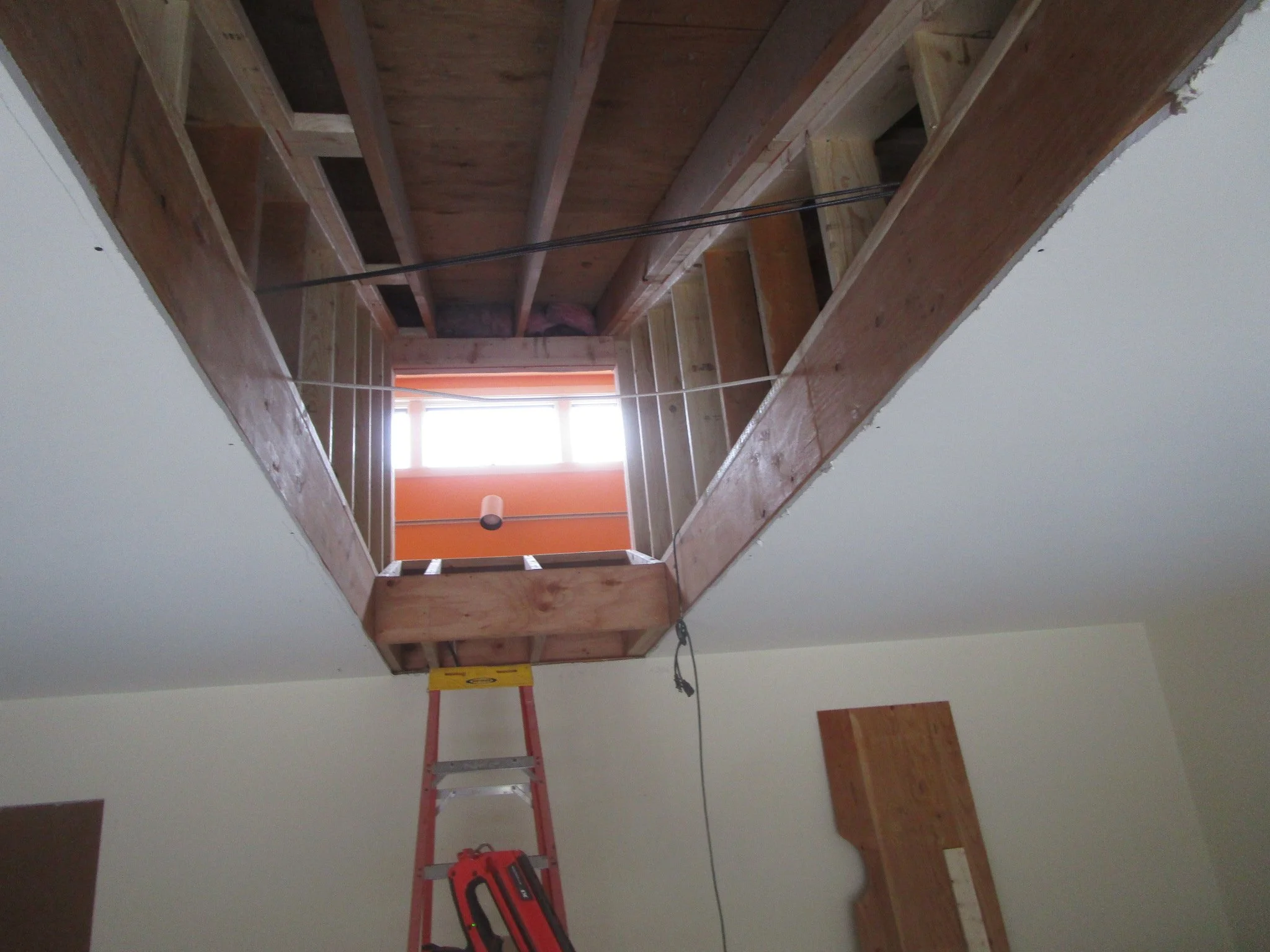

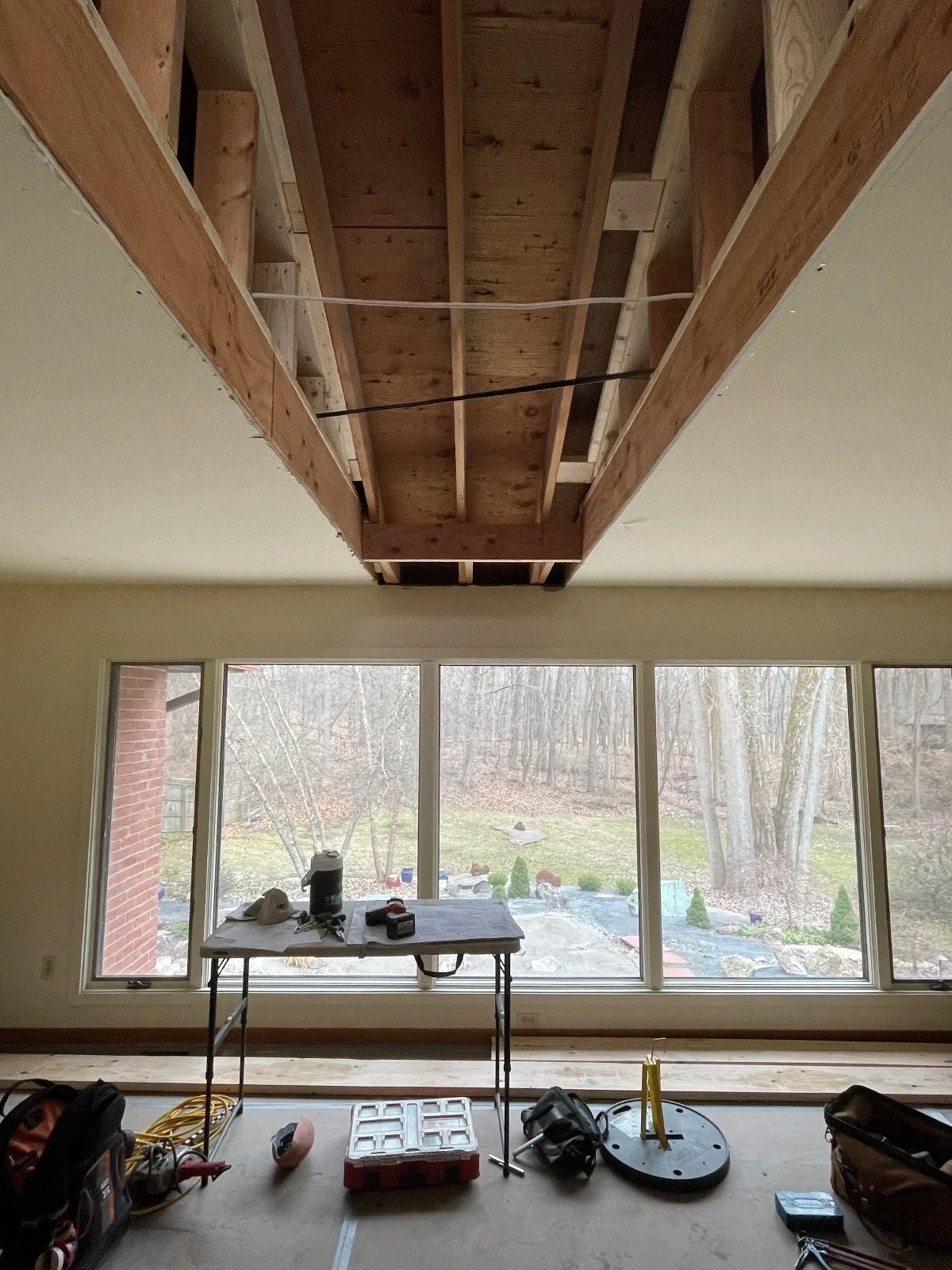

Light well in the living room will bring in light from the front clerestory windows.
Same as above but as seen from the entry.

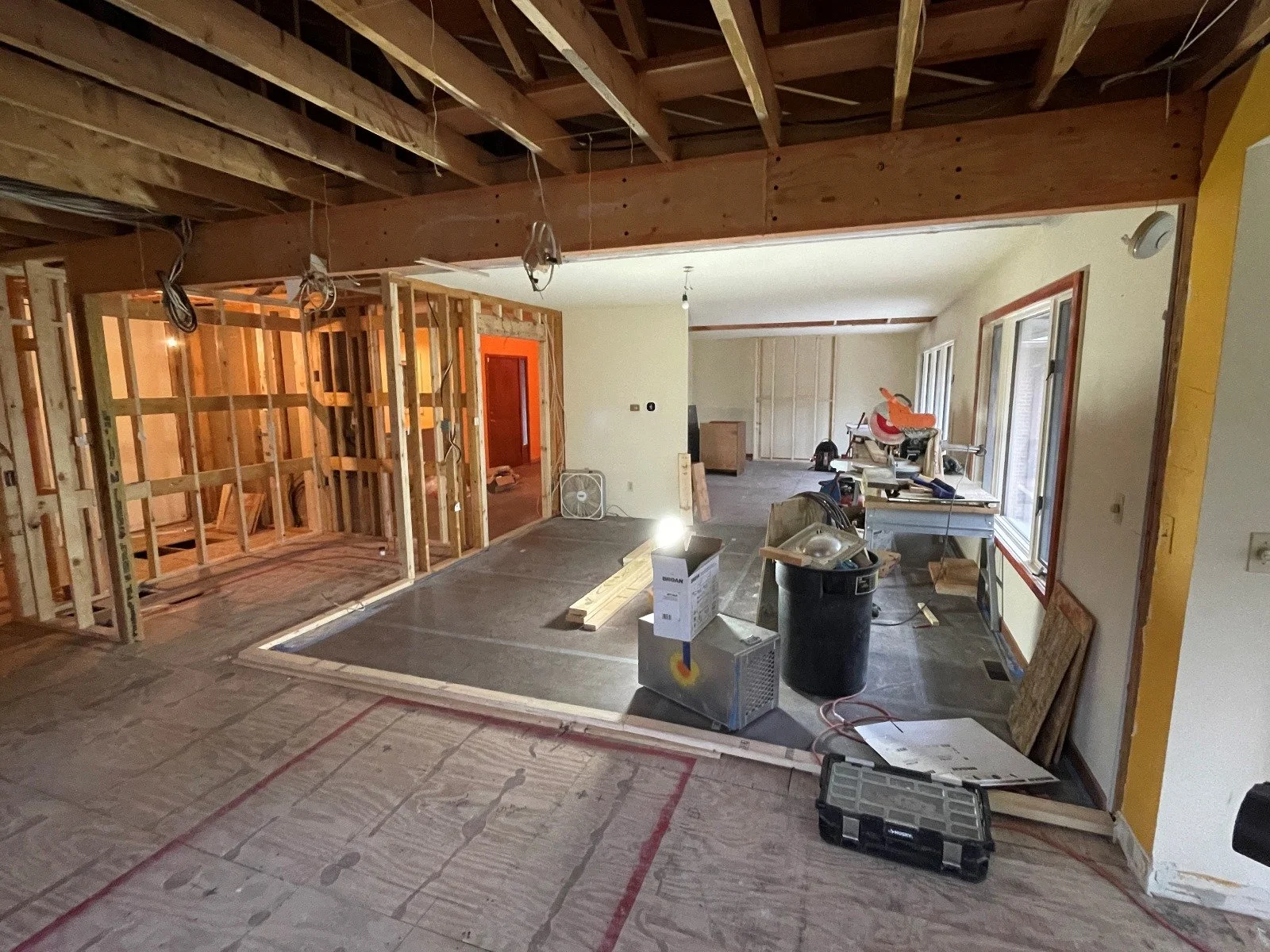

February 28, 2024
This is another perspective of the light well.

The kitchen is framed to receive cabinets.
View from the kitchen into the dining room and living room.
This is the kitchen and sunroom. The paint on the floor shows the layout for future cabinetry.
March 5, 2024

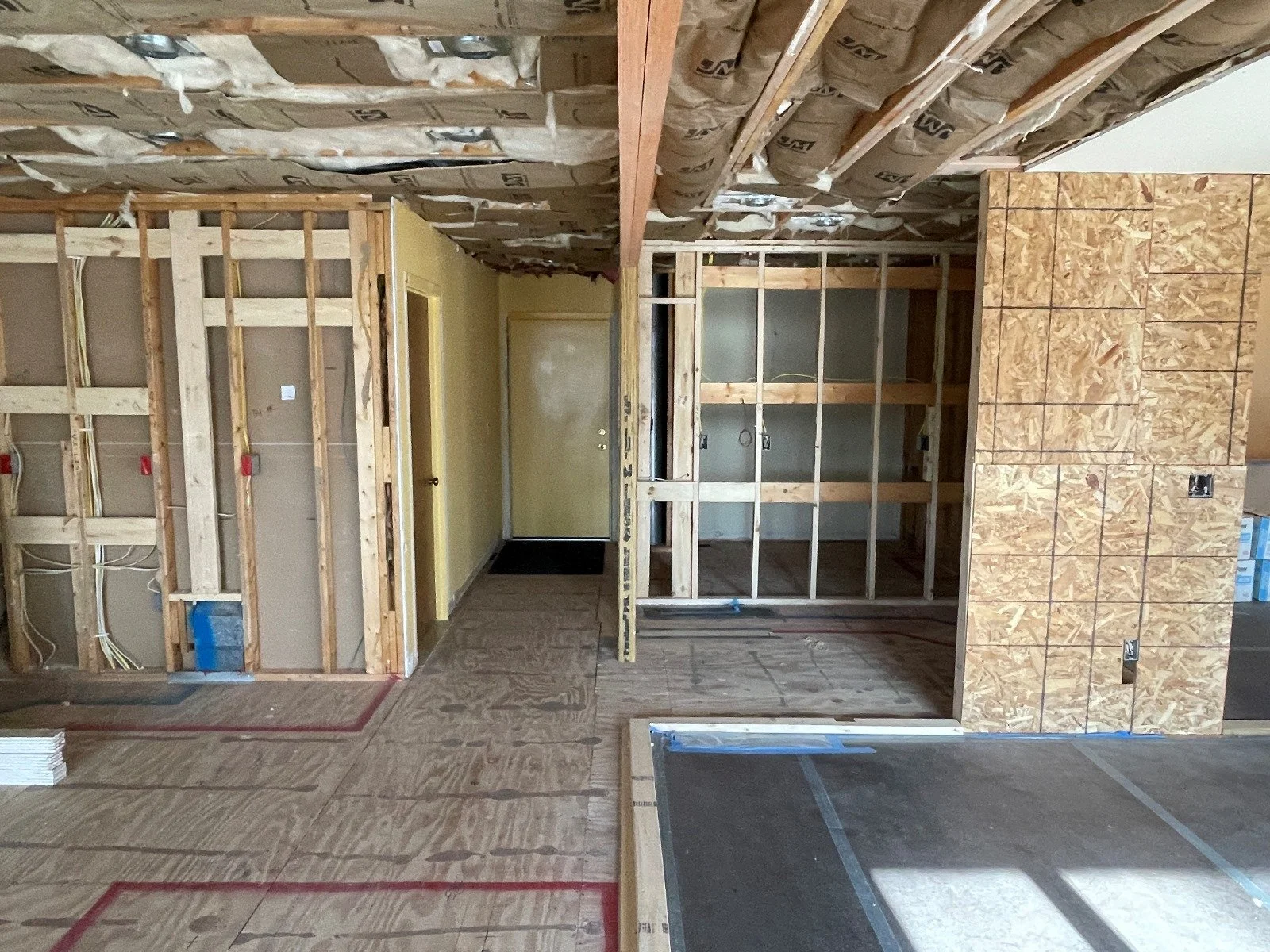

These images show the art niches with lighting.

Foil faced insulation on the exterior wall.

Electrical work is being done in the bedroom wings.
March 10, 2024
“Podz” frame for recessed ceiling light.
Kitchen exterior wall and blue line on the floor are for the wall cabinetry layout.
This is the niche for free-standing tub.
March 15, 2024

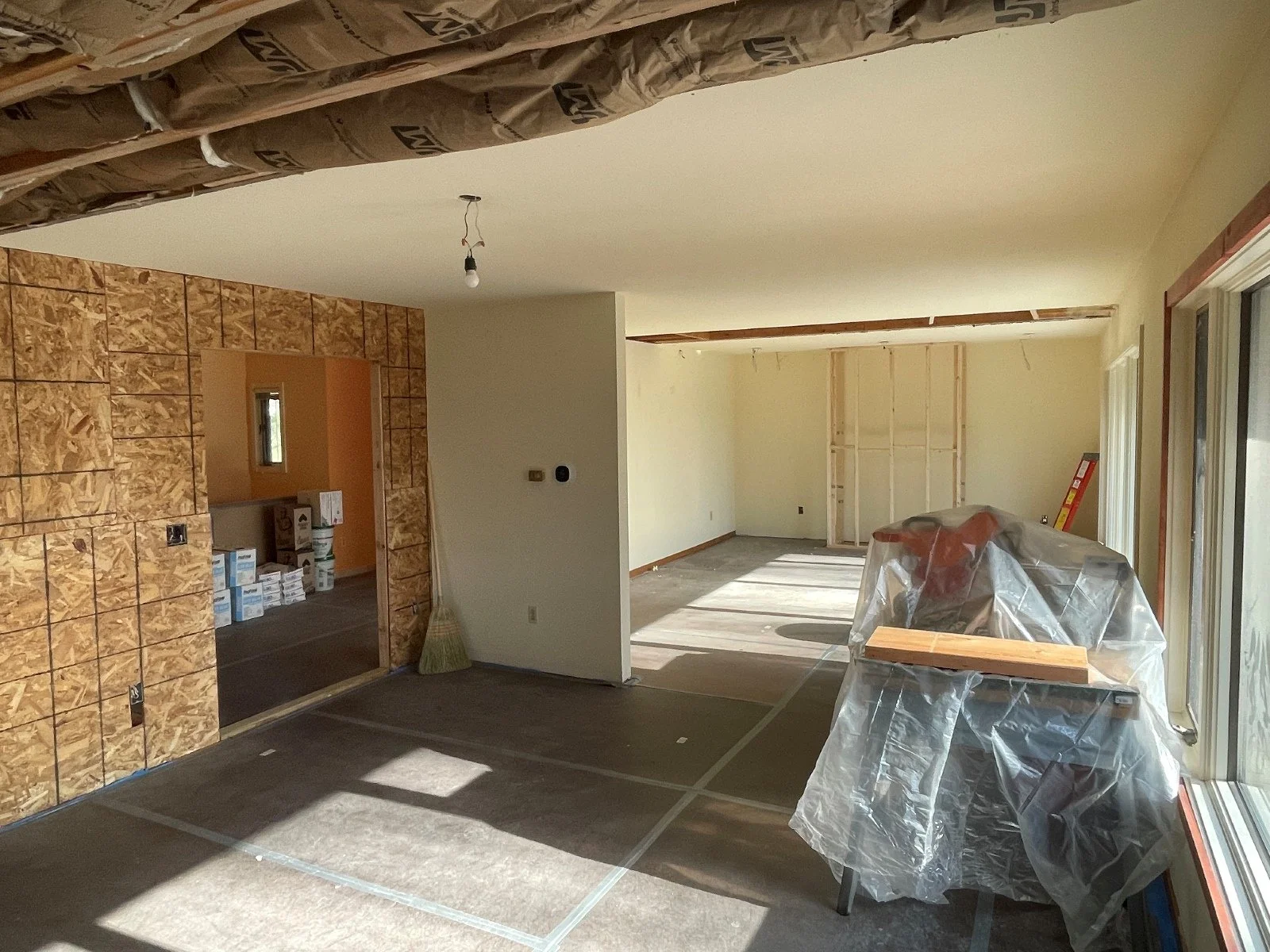

Mudroom and hallway from the garage to the kitchen.
View from the kitchen into the den.
This space will be the kitchen, pantry and laundry.
March 19, 2024

It’s insulation time.
April 9, 2024

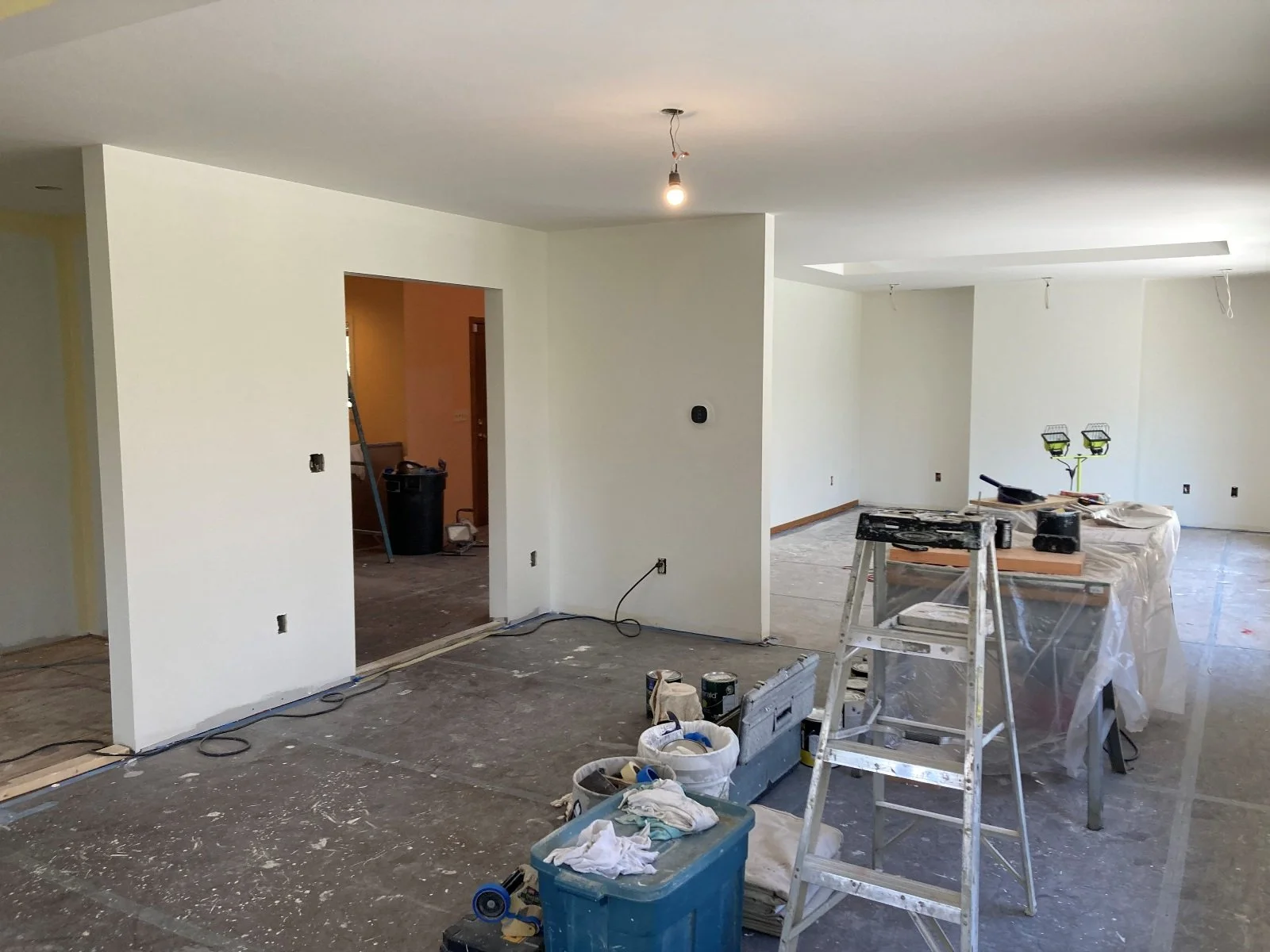

It’s drywall time.
April 24, 2024

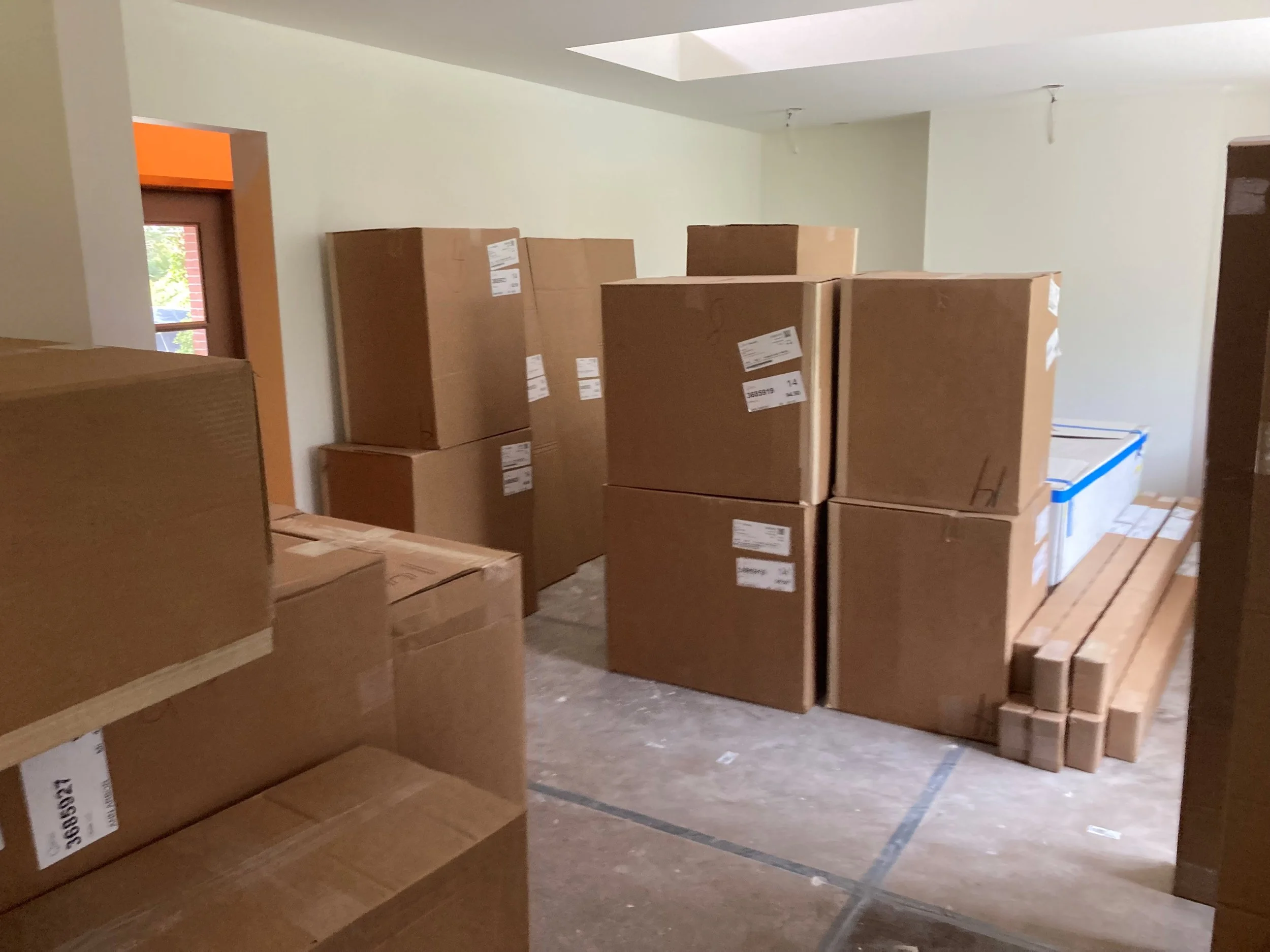

The kitchen cabinets have arrived and are being unloaded.
May 12, 2024

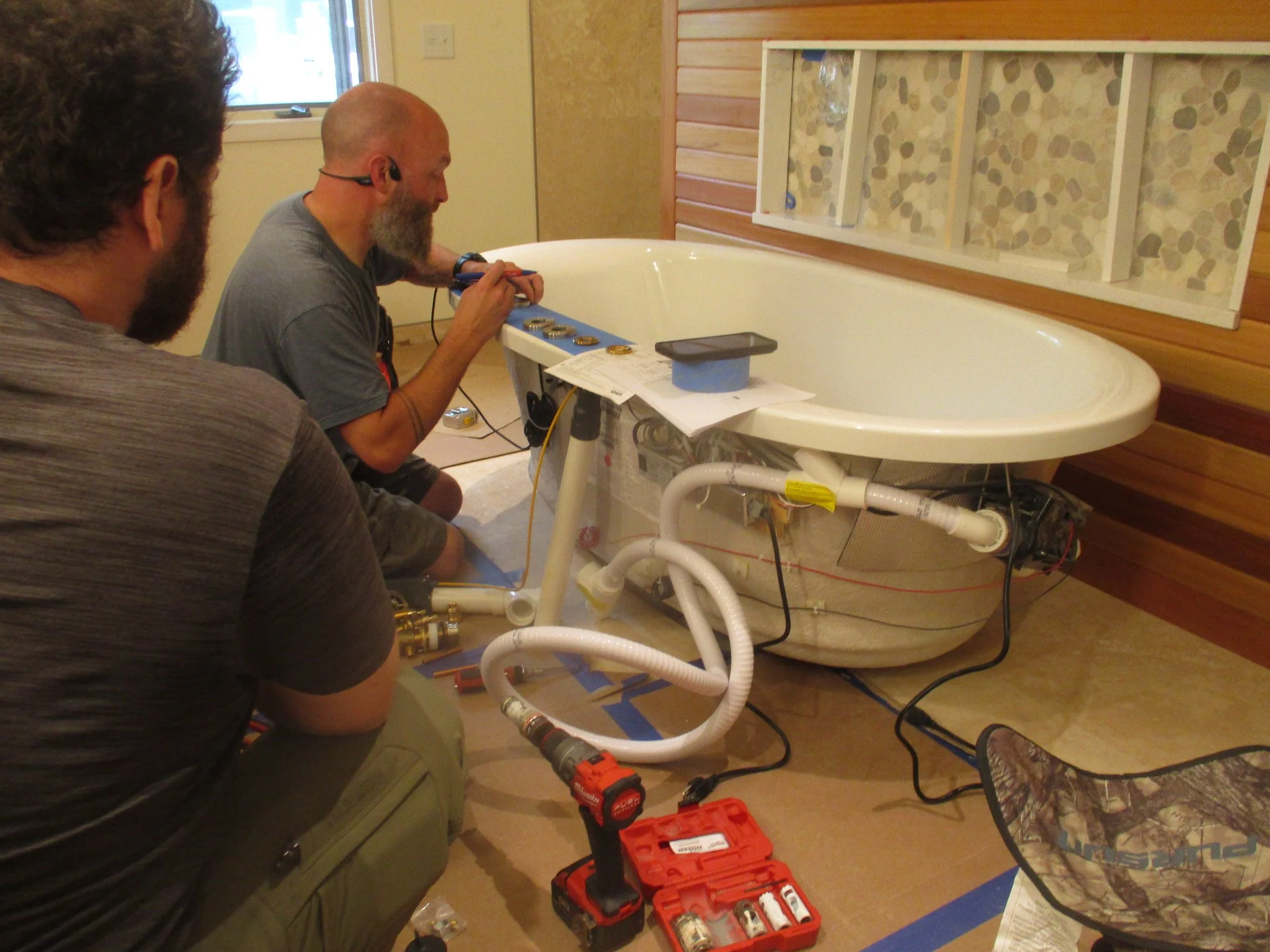

Freestanding tub and pre-finishing the cedar tongue and groove boards that will go behind it.
May 30, 2024
Site built shelving units with incorporated lighting,
Mudroom cabinetry and shelving being installed.

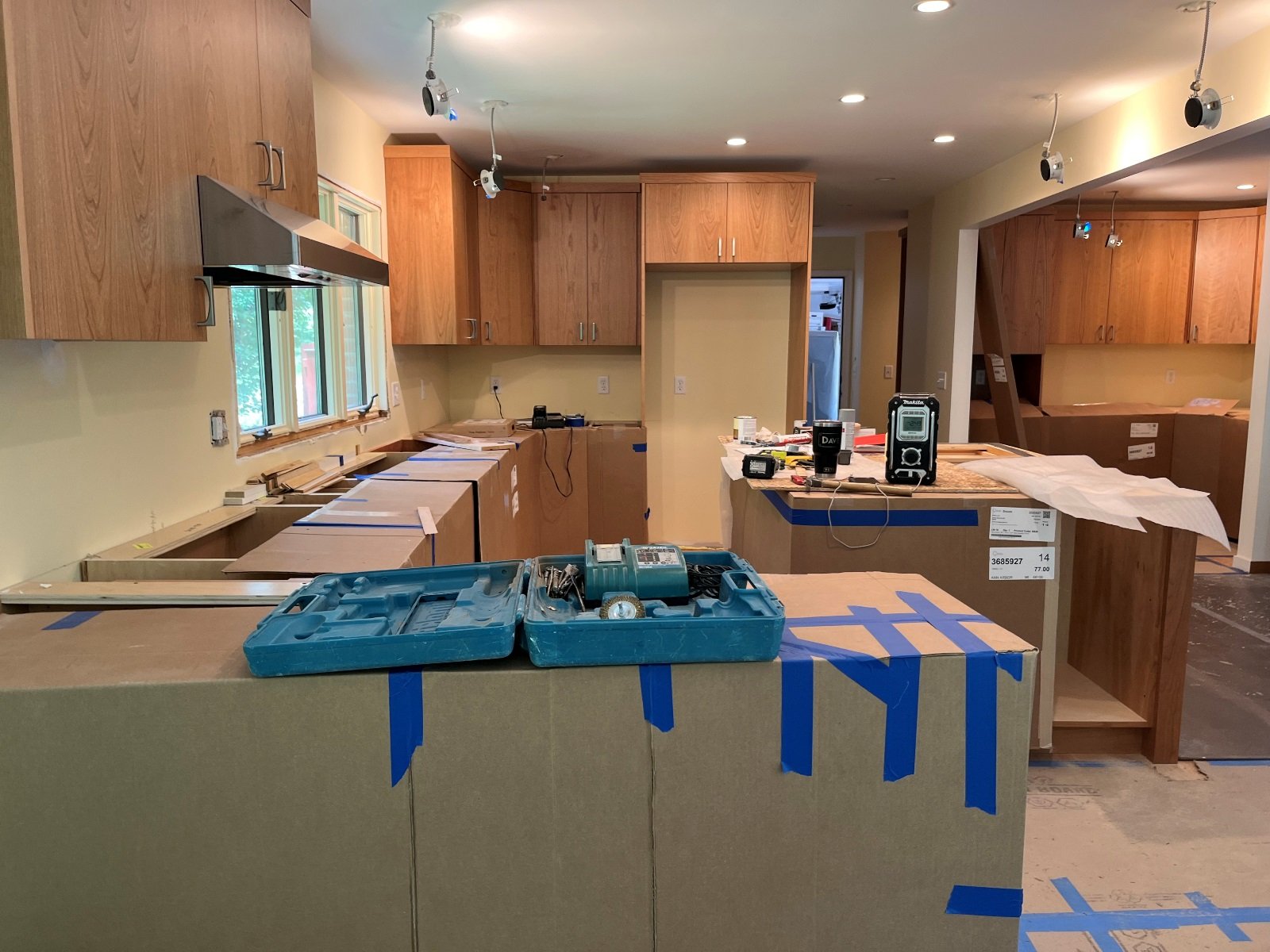

Kitchen cabinets have been installed and protected. Now we are awaiting the arrival of the counters.
June 4, 2024

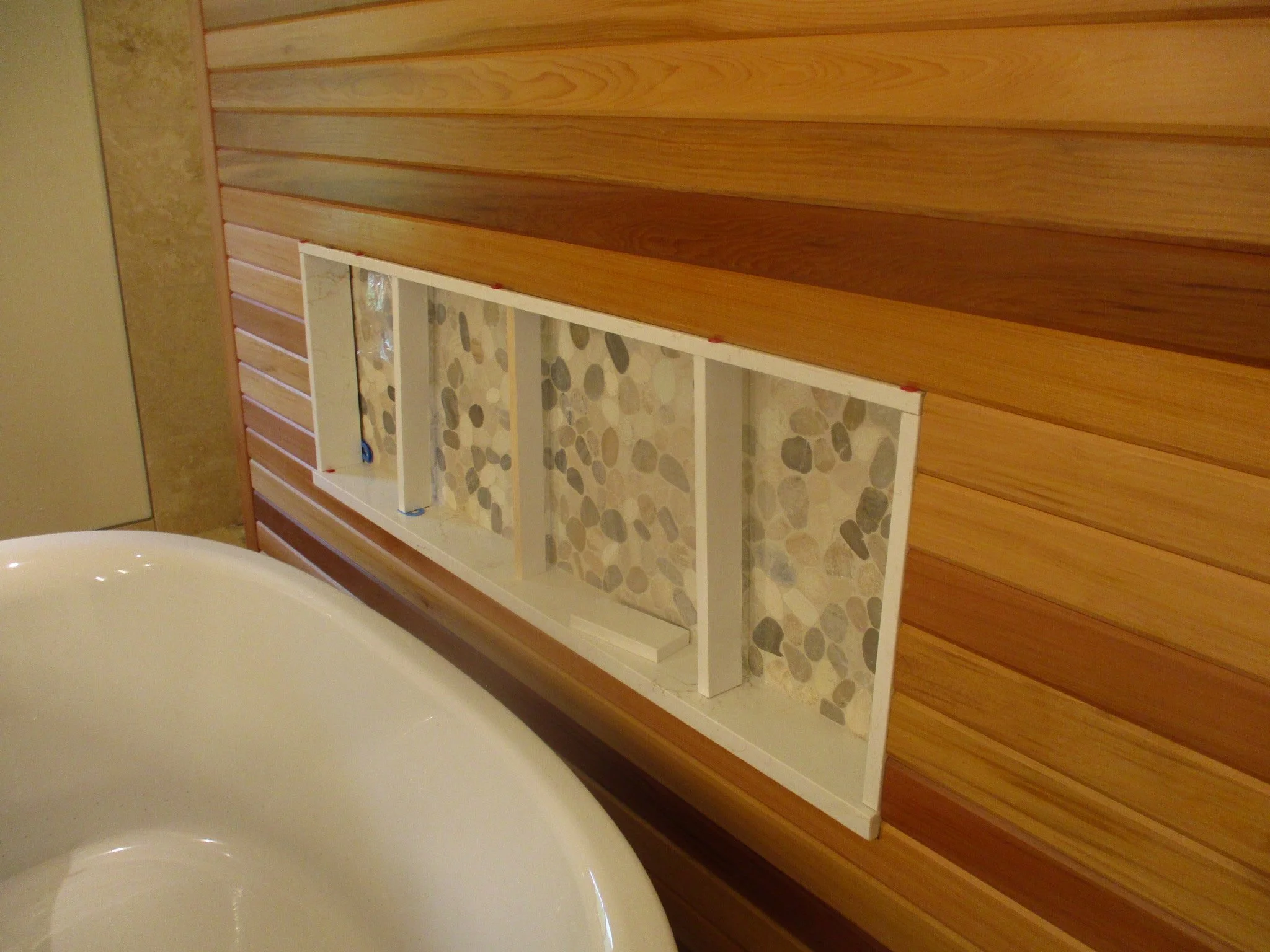

The cedar wall with the tiled niche will be the back drop for the freestanding tub, and the barrier free shower.
The primary walk-in closet.
The gorgeous gold and brown countertop is installed throughout the kitchen.
Along with some wall splash and the kitchen island.
June 10, 2024
Faucet layout and installation for the freestanding tub.
Along with temporary supports for the quartz niche surround.

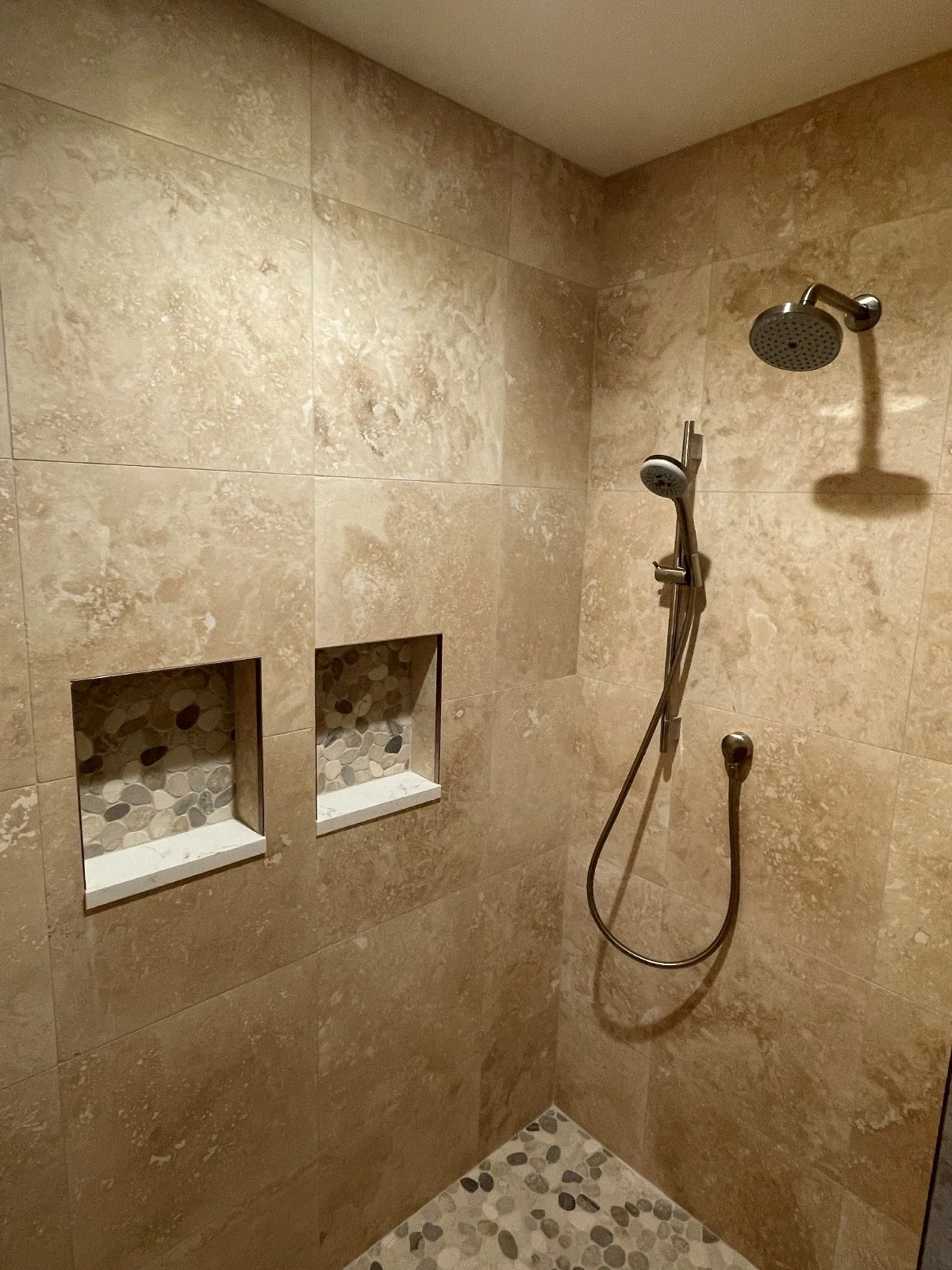

The primary barrier free shower niche tile matches the one by the freestanding tub.
June 21, 2024

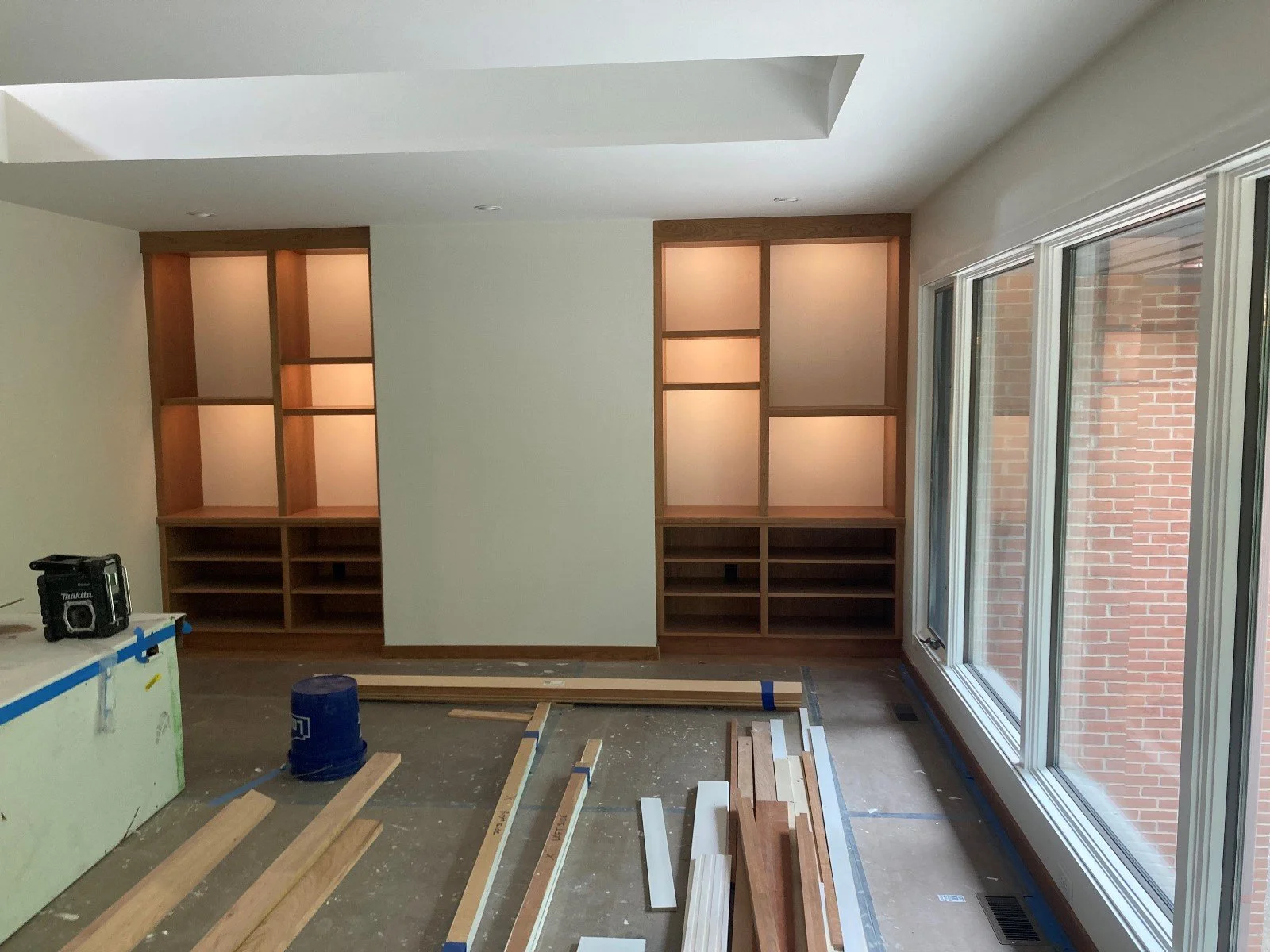

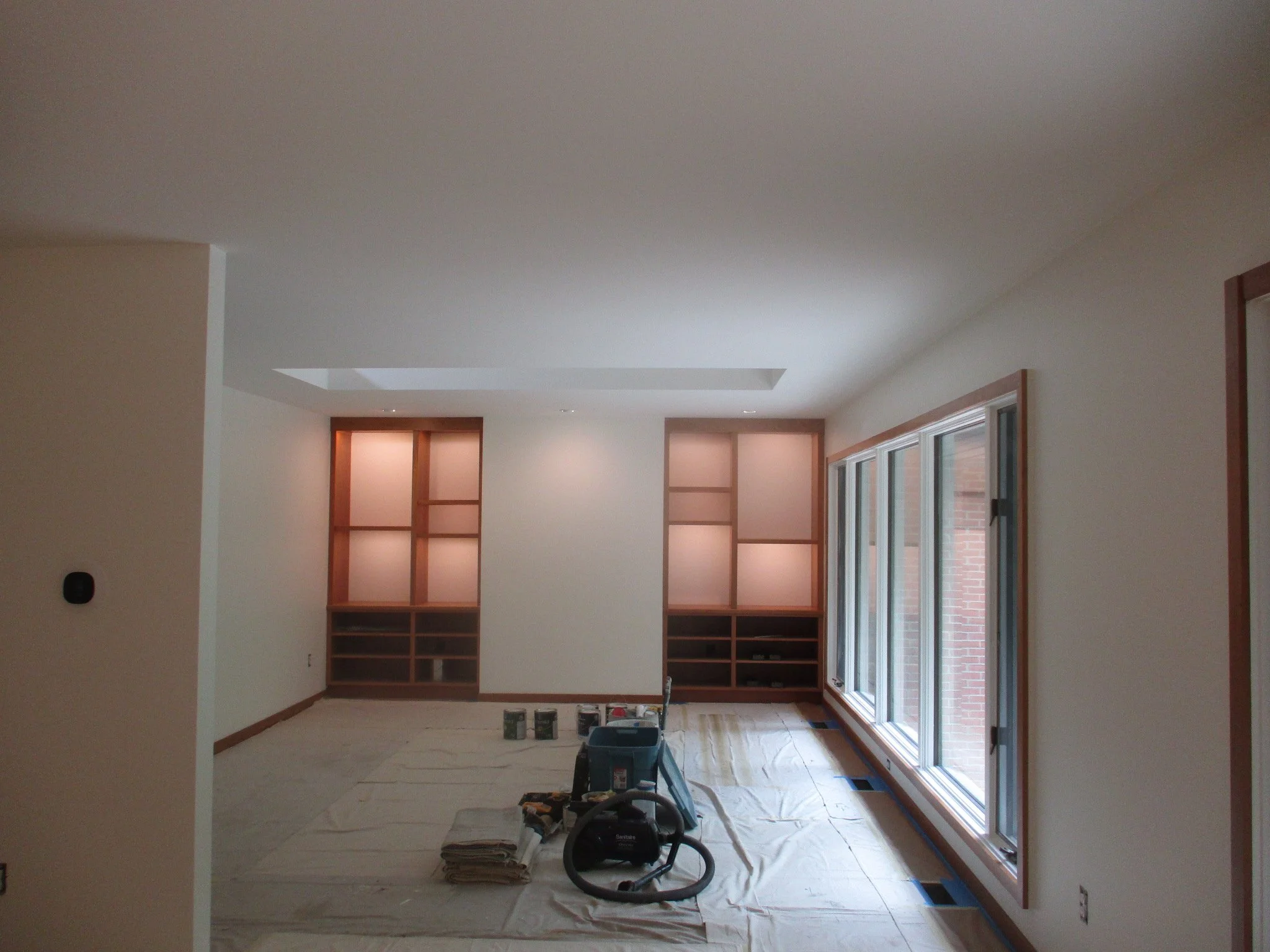

The custom-built shelves with the integrated lighting look way better now that the room is fully painted 😊
Gathering materials for the final push. We’re almost out of here.
July 9, 2024

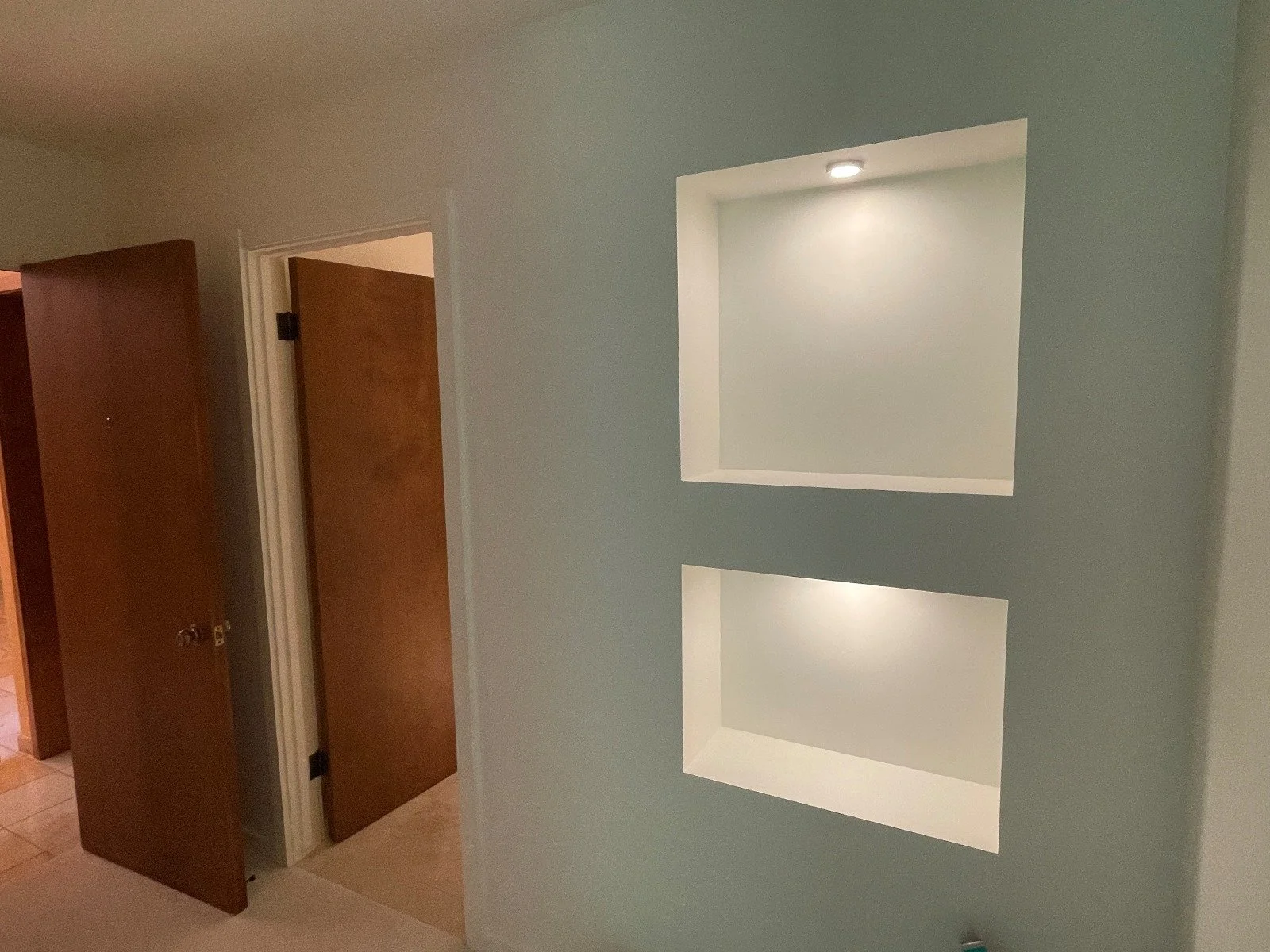

Art niche with lighting in the primary bedroom.
The heated bubble tub in the primary bath and the roll-in shower with the honed pebbles floor.
Lighted toe-kick in the primary bath vanity.
July 15, 2024
And we’re done here. Love our clients and love seeing them happy :-)
